2014-02 Allow PI Transfer

2014-02Allow PI Transfer

Implementation start: October 2014

Estimated duration: Two months

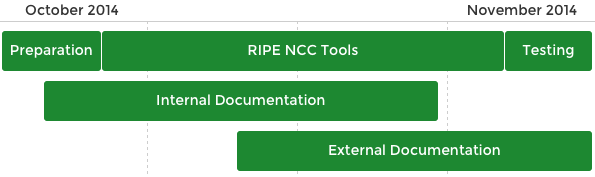

Policy Implementation Status Image


Legend

Preparation

Defining technical requirements, assigning resources

RIPE NCC Tools

Development of internal and external tools

Updating Request Forms

Adjust existing resource request forms

Testing

Testing the functionality of tools

Internal Documentation

Writing new procedures, updating affected procedures, training

External Documentation

Writing new documentation for www.ripe.net, updating legal documentation

Contacting Sponsoring LIRs

Informing sponsoring LIRs of legacy resources about the policy change
